PMC setup and assurance

PMC · Client, consultant and contractor

SOR & NCR: deliverables, expectations and verified closure

What the client should get from the Project Management Consultant, what the contractor should expect from the consultant, and the evidence the organisation needs before calling a non-conformance closed.

A shared standard of service and evidence

PMC means Project Management Consultant here. If the appointment uses OMC or another title, confirm its meaning, scope and delegated powers in writing. Neither the title nor this guide overrides the executed contract.

What the client should receive from the PMC

What the client should receive from the PMC
Deliverable / expectationWhat good looks like
Agreed mandateWritten scope, delegated authority, named decision-makers, review periods and escalation routes; clear separation of PMC, designer and contractor duties.
Reliable registersA linked SOR/NCR register with unique references, exact locations, requirements, owners, agreed dates, current status and evidence links.
Independent assuranceInspection and test records against approved acceptance criteria; designer, specialist and authority acceptance where applicable, not just contractor assurances.
Visible exposureOpen major/systemic items, overdue and repeat findings, authority blockers and recorded cost/programme impact. Unknown amounts remain unknown, not zero.
Decision-ready reportingA dated weekly exception list and monthly trend pack, stating the population, reporting period, verified closures, evidence gaps and decisions required.
Traceable handoverA signed closure certificate and indexed dossier for each closed NCR; an explicit open-item schedule, authority instruments, updated as-builts and residual-risk owners.

SOR or NCR—not interchangeable

SOR and NCR distinction
InstrumentWhen to use itWhat closes it
SOR · Site Observation ReportAn early observation, shortfall or potential deviation not yet established as a formal non-compliance. Record the facts, owner and due date.Proportionate evidence and a recorded verification decision; convert to an NCR when a confirmed breach or repeat pattern warrants it.
NCR · Non-Conformance ReportA confirmed breach of an approved requirement: failed test, rejected inspection, missed hold point, unapproved material or concealed deviation.Defined correction, root cause and preventive action where warranted, objective re-verification and the required approvals and closure dossier.

Safety, structural stability or statutory concerns require immediate containment and escalation to the competent authorised parties. Do not wait for a score, a due date or a prescribed escalation rung.

Seven gates for major NCR closure

Apply these gates to major findings and to authority-linked, designer-linked or concealed-work items. Record why a gate is not applicable rather than leaving it blank. A photograph alone does not prove hidden work, system performance or structural compliance.

Seven closure gates
GateDecisionEvidence to hold
G1 · RequirementFix the requirement and objective acceptance criterionClause, specification, approved drawing revision, ITP hold point or applicable code.
G2 · ContainmentBound the extent and control the affected workDated containment record, marked extent, photographs and hold/release reference.
G3 · Root causeIdentify a controllable system causeEvidence-based five whys or equivalent analysis; not just ‘carelessness’ or ‘subcontractor error’.
G4 · CAPAComplete corrective and preventive actionsNamed owners, measurable actions, dates and proof that the preventive control is effective.
G5 · VerificationRe-inspect or re-test against the criterionResults, method, date, competent verifier, calibration and witness records where required.
G6 · AcceptanceObtain designer/authority acceptance where applicableThe required approved drawing, assessment, inspection record, NOC or certificate; PMC inspection is not a substitute.
G7 · DossierIndex the evidence and update the controlled recordsSigned certificate, evidence index, as-built/handover updates and traceable register entry.

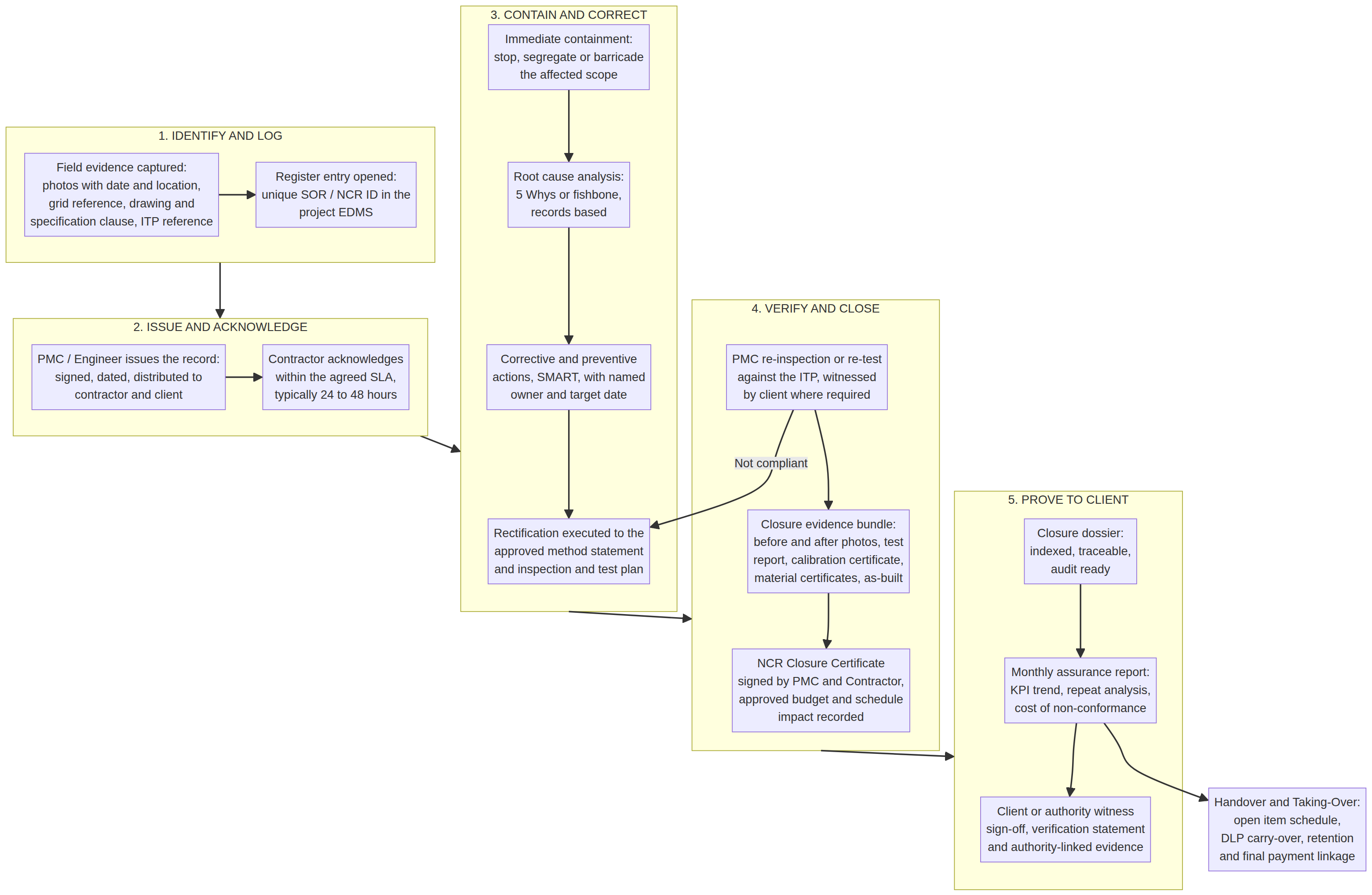

Five-stage NCR lifecycle: identify and log, issue and acknowledge, contain and correct, verify and close, then prove closure to the client.
Supplied workflow diagram · Response periods shown are examples, not universal UAE deadlines. Confirm project-specific periods and witnessing requirements.

The client’s closure and handover pack

  1. Original SOR/NCR, revisions, requirement reference, extent, location and containment history.
  2. Accepted rectification method, root cause and CAPA with accountable owners and effectiveness evidence.
  3. Inspection/re-test results, dates, acceptance criteria, calibration, witnesses and material traceability as applicable.
  4. Designer assessment and the authority’s own acceptance instrument where required.
  5. Signed closure certificate, numbered evidence index, controlled transmittal, updated as-builts and handover records.
  6. Explicit open restrictions, unresolved items and residual risks with an owner, monitoring plan and next review date.

If an earlier closure cannot be substantiated

Preserve the original unaltered. Record an evidence gap, arrange competent independent review and proportionate testing, and issue a dated supplementary retrospective certificate. State “verified compliant”, “non-compliant” or “unable to verify” with the basis and limitations. Do not backdate, delete the earlier record or claim that a certificate removes liability.

Risk alerts support judgement—they do not grant approval

The supplied pack combines workbook formulas, a SQL/Python review and an optional scheduled run. Its critical/high/watch/low bands and cost, delay and ageing thresholds are management assumptions to validate for each project, not statutory limits.

Risk review by project phase
PhasePriority review
Permits and designOpen authority/NOC-linked findings, overdue design/permit responses and missing acceptance instruments.
ConstructionMajor/systemic overdue findings, repeats, concentrated trade failures, containment and recorded commercial exposure.
Testing and commissioningFire/MEP blockers, absent test records, missing verification dates and unsupported closure certificates.
HandoverOpen acceptance blockers, unverified closures, dossier completeness and outstanding authority instruments.
Post-handoverResidual stability/safety concerns, missing evidence, monitoring dates, repeated failures and CAPA effectiveness.

These downloads are reference tools, not a live connection to your organisation’s records. The site does not run the uploaded SQL/Python, import sample records or email scheduled alerts. Have your authorised team validate the runner and mappings before using real project data.

Supplied reference library

Source references: PMC-QA-ART-001, PMC-QA-AUD-004 and PMC-QA-SQL-005. Files are supplied reference materials, not authority approvals or verified project records. The workbook and generated report contain illustrative examples; remove them before issue. Replace placeholders and agree project response periods.

  • SOR and NCR practitioner article

    PDF · Source guidance on classification, responsibilities, escalation and proving closure.

    Download
  • SOR / NCR control workbook

    Excel · 20 sheets, including registers, RACI, forms, closure audit and risk alerts. Contains illustrative sample NCRs—delete before use.

    Download
  • Major NCR close-out field aid

    PDF · Seven gates and evidence checklist. Its suggested time boxes must be agreed against the project contract.

    Download
  • Risk automation and closure certificate

    PDF · Query catalogue, scoring model and retrospective certificate field-by-field guidance.

    Download
  • Complete supplied reference package

    ZIP · Articles, editable forms, field aid, diagrams, authority research, audit protocol, letter templates, SQL, Python and a sample report. Legal references and service routes require current verification.

    Download

Contract clause numbers, automatic escalation periods, withholding/back-charge proposals, legal article references and retention periods in the source files are not independently verified here. Check the current law, applicable authority, executed contract and Particular Conditions with qualified advisers before issuing notices or relying on legal conclusions.

Next step

Turn this into evidence you can hand over

Replace scattered spreadsheets and WhatsApp threads with one HSE operations system built around UAE authority expectations.

  • Built around UAE authoritiesADOSH-SF, Trakhees, DM, DCD, MOIAT and ISO 45001 structures.
  • Usable the same dayTemplates and registers are pre-filled with your company details.
  • Evidence, not just formsEvery record carries dates, signatures and an export you can hand over.
